• North Queensland Region
  • Natural Disaster Program
Location
Mount Spec Road, between the Bruce Highway intersection and Paluma
Timing
Reconstruction works are expected to be complete in June 2027, construction and weather conditions permitting.
Status
Construction

Mount Spec Road reconstruction works

The Queensland Government is repairing Mount Spec Road after substantial structural damage following record rainfall in early 2025. This includes more than 60 landslips, with 6 major and 2 high-risk sites.

The road was closed on 29 January 2025 due to safety concerns.

Following emergency works, the road reopened on 18 August 2025 to the public via a restricted access permit system while the 2 high-risk sites were addressed.

The first high-risk site involved the safe removal of an unstable 400-tonne boulder near Little Crystal Creek in November 2025. The second high-risk site saw the installation of a three-layer shipping container safety wall consisting of 27 large shipping containers.

On 29 March 2026, the vehicle permit system was lifted following positive geotechnical safety assessments at the high-risk sites.

Heritage listing

While Mount Spec Road's heritage listing did not significantly impact emergency works, it must be considered in the design and full reconstruction of the road.

Its heritage listing covers the road and associated infrastructure, including bridges, culverts, stone pitched kerb and channels, and road furniture. While this presents challenges, the design and associated works will still restore the asset to its pre-event function.

Benefits

  • Contributes to economy
  • Contributes to regional growth
  • Restores damaged infrastructure

Key features

  • Restoring access for communities and businesses
  • Restoring damaged roads and road surfaces
  • Restoring damaged slopes and batters.

Funding

The recovery works are jointly funded by the Australian and Queensland Governments through the Disaster Recovery Funding Arrangements (DRFA).

Current status

The contract for the reconstruction works was awarded to Civil Mining & Construction Pty Ltd in October 2025.

Reconstruction works have increased on Mount Spec Road to a 24-hour, 7-days-a week schedule.

Repairs are being carried out across 35 damaged sites, along with minor pavement and culvert reconstruction.

Current works include slope stabilisation, spraying Geobinder to minimise erosion, and layering of fibrecrete.

The geometry of the road in conjunction with the ongoing works means the road is not suitable for all vehicles. The types of vehicles deemed suitable have not changed since the permit system was removed - if a vehicle was previously allowed, it remains suitable. As a guide:

  • Vehicles with small trailers are suitable – for example, a dual cab 4WD towing a box trailer.
  • Larger trailers are not suitable – including larger caravans and similar long or heavy trailer combinations.

Vehicle escort systems

A daytime vehicle escort system has operated since December 2025.

The service operates from 6am to 6pm Monday-Sunday, with escorted movements departing on the hour, every hour with 2 vehicle escorts operating simultaneously at both entry points to Mount Spec Road. The final service departs at 6pm.

If traffic volumes increase, the daytime vehicle escort system may be amended to safely manage vehicle movements which may include limiting vehicle numbers under scheduled escorts, pausing scheduled escorts in one direction or adding additional escorts.

The nighttime vehicle escort system will continue to operate between the hours of 6pm and 6am Monday-Sunday during the scheduled road closure. This service requires pre-booking and accommodates shift workers and emergency travel.

Mount Spec Road reconstruction works

Video Transcript
The large boulder located near Little Crystal Creek bridge was successfully blasted earlier in November 2025.
Slope stabilisation solutions explained. The solutions featured here are for example purposes only and not indicative of the specific design required for the pictured damaged slope. Slope stabilisation solutions are based on geotechnical assessments and the needs of each individual site.  Gabion baskets Gabion baskets are box-shaped wire of galvanised steel mesh filled with rock or concrete. When stacked, they form a wall to stabilise roads constructed on a slope. > Mesh installation Constructed from a composite 3D mat structure embedded in a steel wire mesh, this reinforcement provides tensile strength and erosion protection and is used in conjunction with soil nails to reinforce slopes.  Soil nails Soil nails are steel bars grouted into holes drilled into the slope. Up to 12m long, they are used in combination with shotcrete or mesh to stabilise slopes. Rockfill embankment Rockfill embankments rebuild and protect damaged slopes, using sized rocks to slow water flow and prevent erosion.
Slope stabilisation solutions explained
The solutions featured here are for example purposes only and not indicative of the specific design required for the pictured damaged slope. Slope stabilisation solutions are based on geotechnical assessments and the needs of each individual site.

Gabion baskets
Gabion baskets are box-shaped wire of galvanised steel mesh filled with rock or concrete. When stacked, they form a wall to stabilise roads constructed on a slope.

Mesh installation
Constructed from a composite 3D mat structure embedded in a steel wire mesh, this reinforcement provides tensile strength and erosion protection and is used in conjunction with soil nails to reinforce slopes.

Soil nails
Soil nails are steel bars grouted into holes drilled into the slope. Up to 12m long, they are used in combination with shotcrete or mesh to stabilise slopes.

Rockfill embankment
Rockfill embankments rebuild and protect damaged slopes, using sized rocks to slow water flow and prevent erosion.

Project map

Mount Spec Road rehabilitation project map

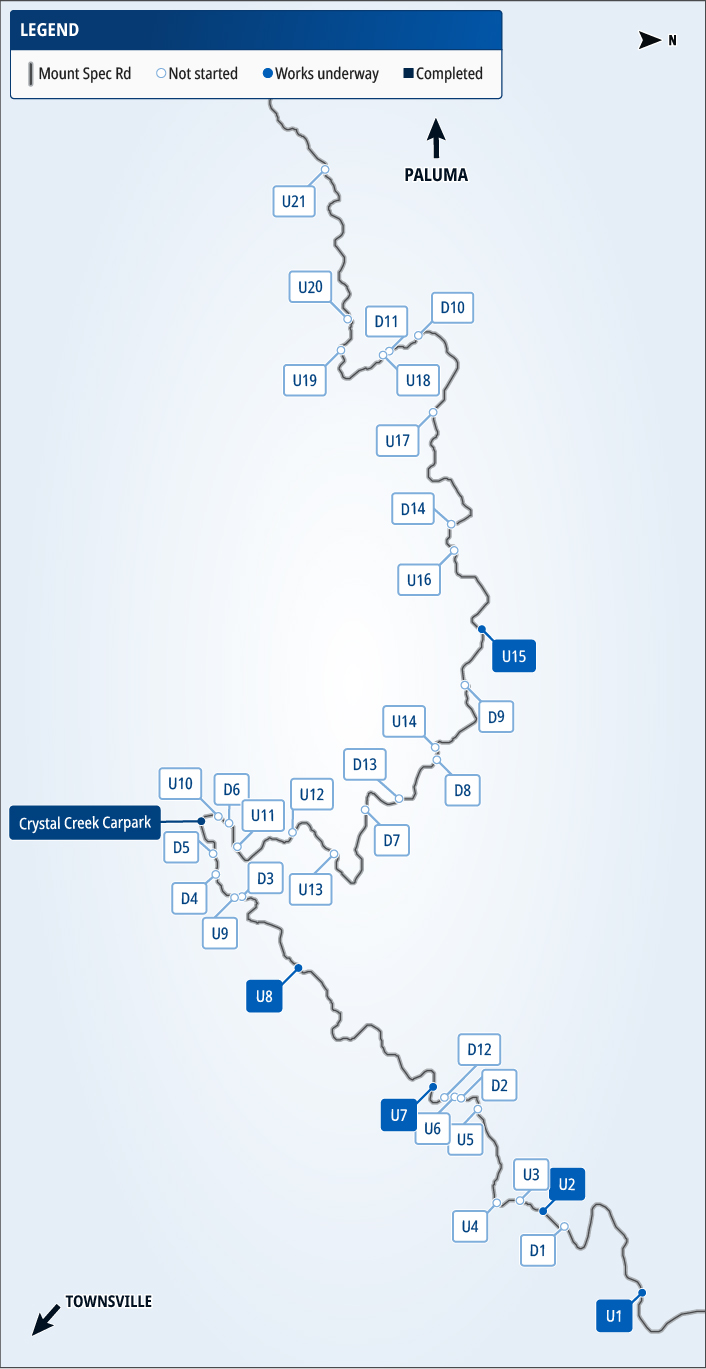

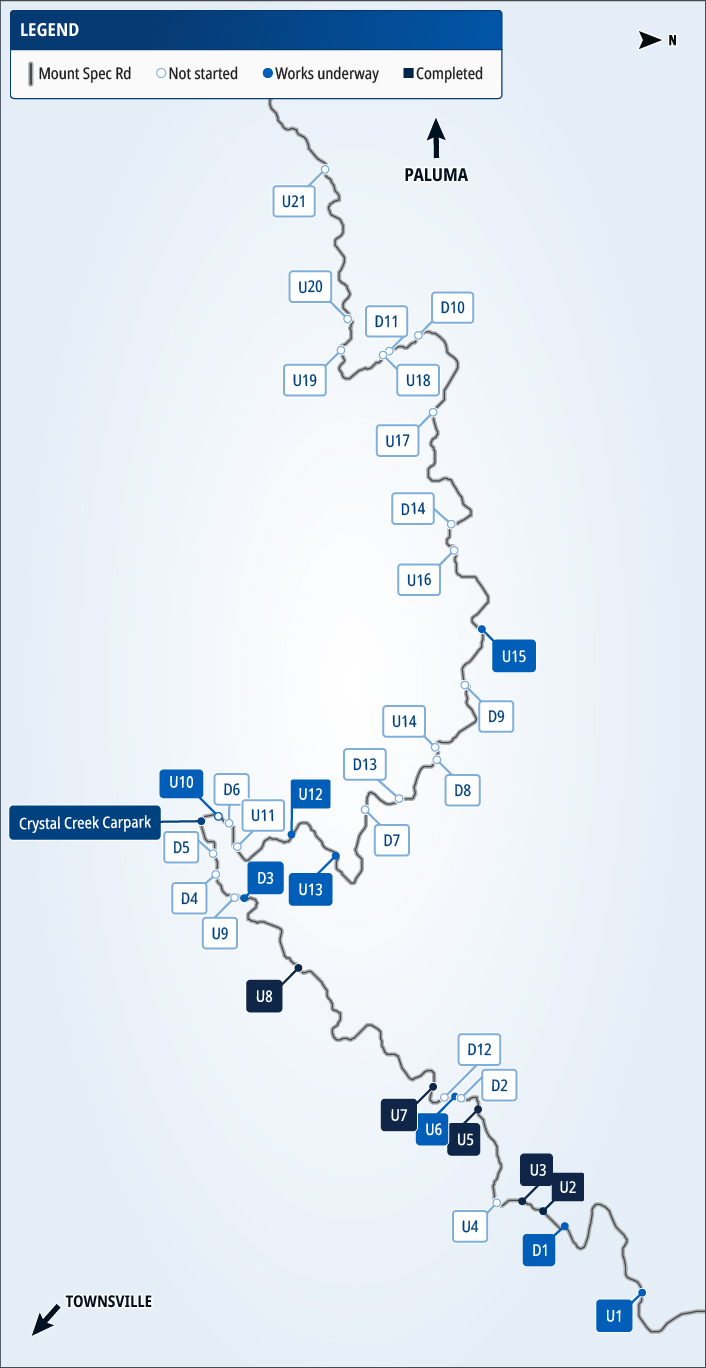

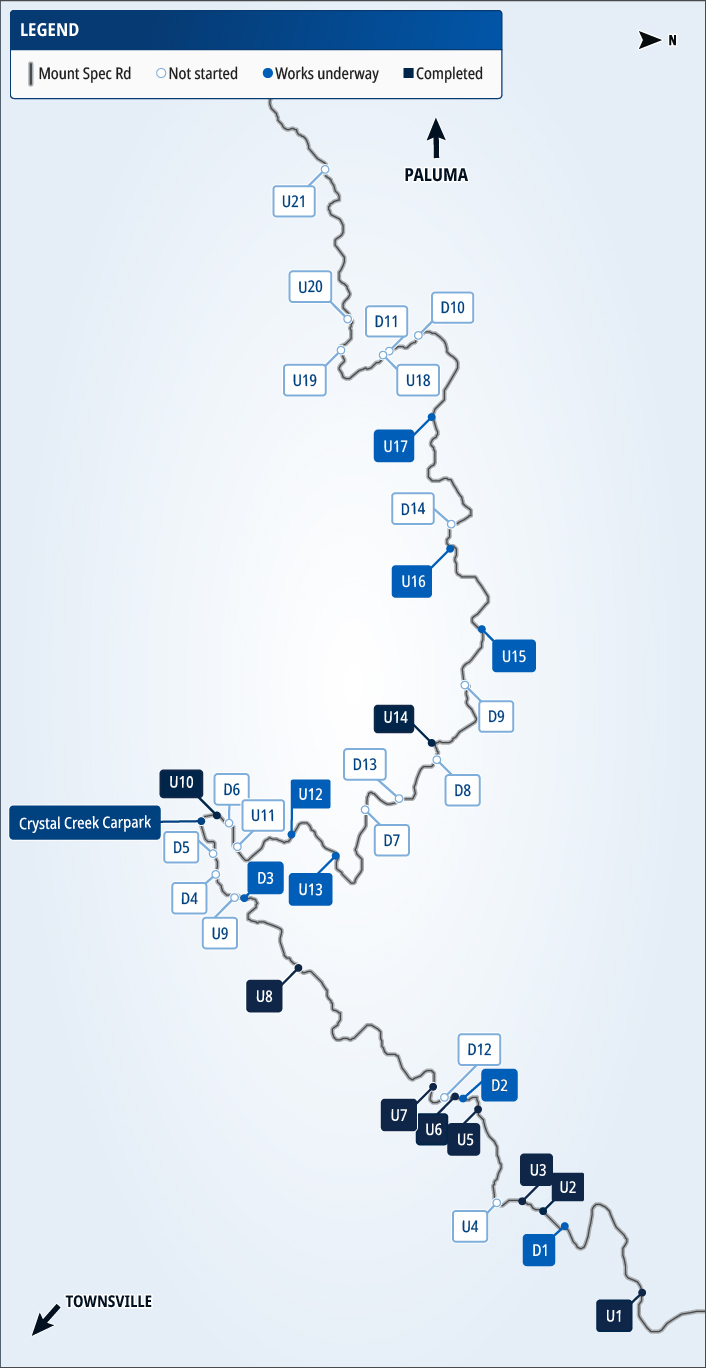

Map showing the location of reconstruction works along Mount Spec Road, between Paluma and Townsville. There are 35 damaged sites identified for repairs that are marked as ‘U’ for upslope and ‘D’ for downslope.

Last updated: 10 April 2026
