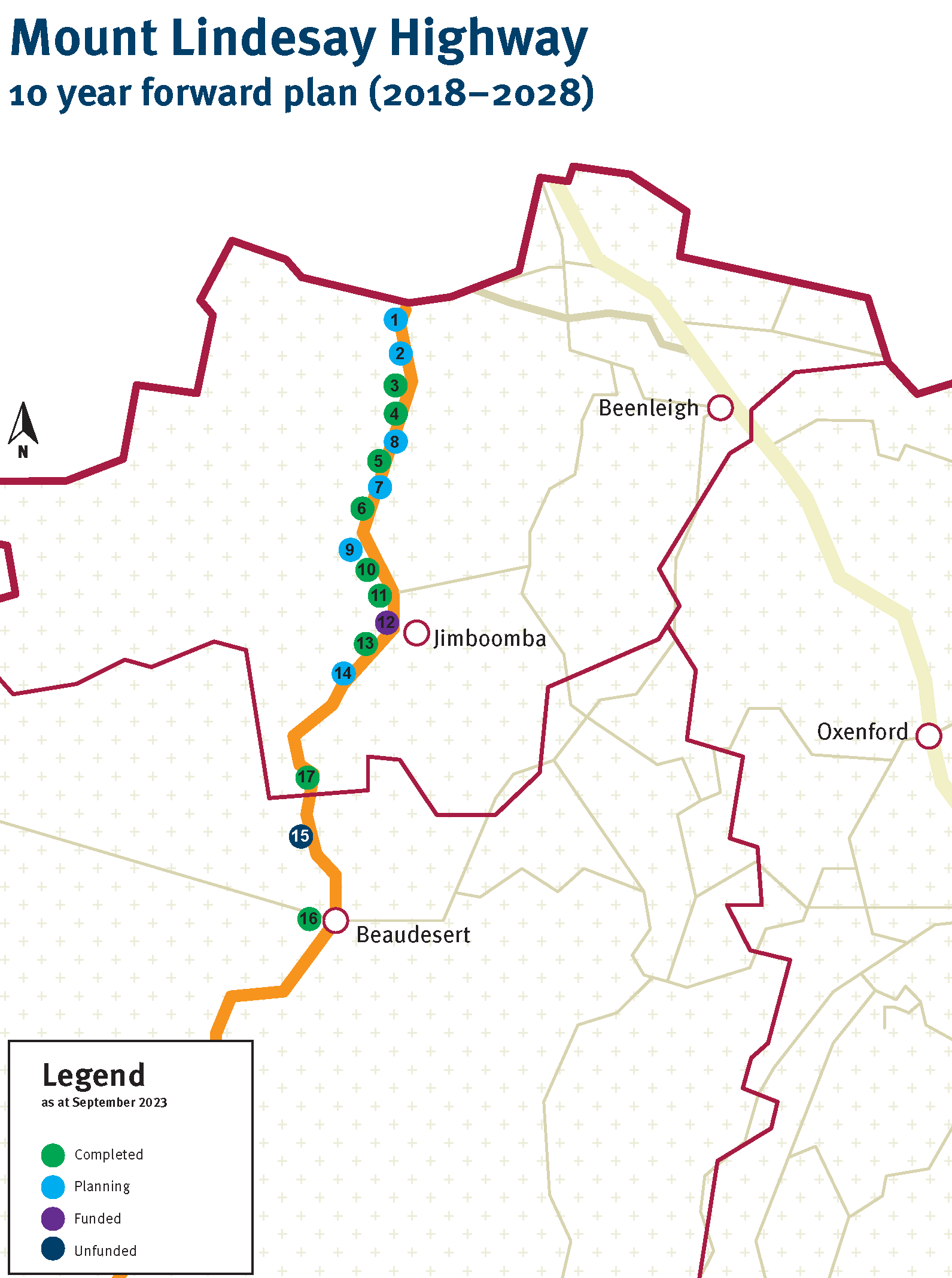

10 Year Forward Plan (2018-2028)

Program map

Mount Lindesay Highway 10 Year Forward Plan 2018-2028 Program map

Upgrade projects

Mount Lindesay Highway (Brisbane–Beaudesert), Logan Motorway to Park Ridge Road, planning – Cost: $1.5 million

1. Logan Motorway to Park Ridge Road
  • Improve connectivity, travel times and safety
  • Six lane widening
  • Currently in planning 2023-2027
2. Green Road/Coronation Road Interchange
  • Project planning - combined with Project 1
  • Increase capacity and improve travel times
  • Currently in planning 2023-2027
3. Rosia Road to Stoney Camp Road
  • Cost: $22.4 million
  • Increase capacity and improve travel times and safety
  • Delivered 2020
4. Stoney Camp Road to Chambers Flat Road
  • Cost: $75 million ($37.5 million Australian Government, 37.5 million Queensland Government)
  • Increase capacity and improve travel times
  • Delivered 2023
5. North Maclean safety improvements
  • Cost: $20 million ($16 million Australian Government, $4 million Queensland Government)
  • Improve safety
  • Delivered 2019
6. South Maclean safety improvements
  • Cost: $14 million
  • Improve safety
  • Delivered 2020

Mount Lindesay Highway (Brisbane–Beaudesert), North Maclean to Jimboomba, planning – Cost: $4.1 million

7. Greenbank Road to Stockleigh Road
  • Increase capacity and improve travel times, safety, reliability and flood immunity
  • Currently in planning 2023-2026
8. Chambers Flat Road to Greenbank Road
  • Increase capacity, improve safety and travel times
  • Currently in planning 2023-2026
9. Stockleigh Road to Camp Cable Road
  • Increase capacity and reliability
  • Currently in planning 2023-2026
10. Camp Cable Road intersection
  • Cost: $7 million
  • Increased capacity, reliability and safety
  • Delivered 2016
11. Camp Cable Road to Johanna Street, Jimboomba
  • Cost: $19.6 million
  • Increase capacity and improve travel times, safety, reliability and flood immunity
  • Delivered 2020
12. Johanna Street to South Street through Jimboomba
  • Cost: $57.4 million ($42.4 million Australian Government, $15 million Queensland Government)
  • Increase capacity and improve travel times
  • Detailed design
13. Millstream Road intersection
  • Cost: $2 million
  • Increased safety and improved travel times
  • Delivered 2015
14. South Street to Cedar Vale Road
  • Cost: $1 million (project planning)
  • Increase capacity, improve safety and travel times
  • Currently in planning 2023–2027
15. Cedar Vale Road to Beaudesert
  • Cost: Currently unfunded
  • Improve safety
  • Planning beyond 2026
16. Beaudesert Town Centre Bypass
  • Cost: $27.5 million
  • Improved safety and reliability
  • Delivered 2017
17. Jimboomba to Beaudesert safety improvements
  • Cost: $17.137 million ($16.865 million Queensland Government, $0.272 million Logan City Council)
  • Improve intersections
  • Delivered 2021–2022
